Pool Renovation
Overview
| Address | 92 W. Orme St |
|---|---|
| Current Project Phase | Planning and Design |
| Project Start | Study: June 2024 |
| Project Construction | Phase 1: Spring 2026 Phase 2: Fall 2025-Spring 2027 |
| Project End | Expected Late Spring 2027 |
| Size | 3 acres - Pool and Poolside Park |
| Current Amenities | Zero-depth entry pool, lap pool, concession and bathhouse, seating and patio, parking, playground. |
April 1st has been declared April Pool's Day!
Saint Paul Parks Conservancy, a nonprofit organization, is working to raise funds on our behalf for this project to help improve and enhance this important community space.
Learn more and support the pool through Saint Paul Parks Conservancy with your donation!
Overview
The City’s community pool opened in the 1950s with major reinvestment in 1999. The pool facility is still popular, but it is showing its age. Following a study of possible improvement scenarios and community engagement about the pool's future, the City Council authorized a 'mid-tier' renovation of the pool.
The two-phased project will include:
- Replacement of the pool vessel, including new lighting
- New mechanical equipment
- Refurbishment of the existing slide
- Pool deck enhancements
- Bathhouse improvements
Draft Pool Plans

- 1 Image showing renovated bathhouse exterior entrance with a refurbished design
- 2 Renovated bathhouse exterior poolside showing a new blue wall and mural
- 3 Bathhouse Interior
- 4 Deck Enhanced View 1 Labeled
- 5 Deck Enhanced View 2
- 6 Deck Enhanced View 3 Night
- 7 Deck Enhanced View 3
- 8 Deck Enhanced View 4
- 9 Renovated pool deck with new and expanded seating, more shade.
More Information
Step 1: Analysis
With the support of an aquatics consultant, the city considered and assessed four options for the pool's future. Solutions included:
- Reinvestment: significant investment in the existing facility, mostly health, safety, and structural upgrades
- Replacement: significant investment in a new pool facility, including new layout and amenities, on the same site as the existing pool
- Relocation: a new pool facility is built at a different site within the community, possibly in connection with a community or recreation center facility. We should note that no site has been identified, and a community/recreation center project has not been approved.
- Redistribution: the existing pool is decommissioned and replaced with smaller wading pool(s), splash pad(s), and/or other water amenities distributed throughout the community
With community feedback, the Relocation and Redistribution options were ruled out. Following the existing pool assessment, two alternative plans were presented to the City Council. The consultants found the bathhouse to be in good condition, with only regular repairs, maintenance, and cosmetic updates required. As the updates to the bathhouse are considered routine maintenance, the updates are not included in the cost estimates below.
- 25-Year Reinvestment Solution: A medium-term solution to upgrade the pool facility
- Early Cost Estimate: at least $1,296,000
- 50-Year Replacement Solution: A long-term solution to replace most of the pool facility.
- Early Cost Estimate: at least $4,047,000
- Given the extensive renovation, the 50-Year Replacement Solution would present the opportunity to reconfigure the pool(s) layout.
Burbach's assessment can be viewed here.
Step 2: Design (we are here)
Following a review of the options, the City Council determined that the 25-Year Reinvestment Solution was the preferred option given financial considerations. City Council asked staff to advance the project to make improvements as soon as possible, acknowledging that a pool renovation requires planning, design, and coordination.
The city retained Amcon Construction to provide construction management and administration services. A design team, led by landscape architecture firm Damon Farber, is leading design.
Following an in-depth assessment, the design team developed two design alternatives.

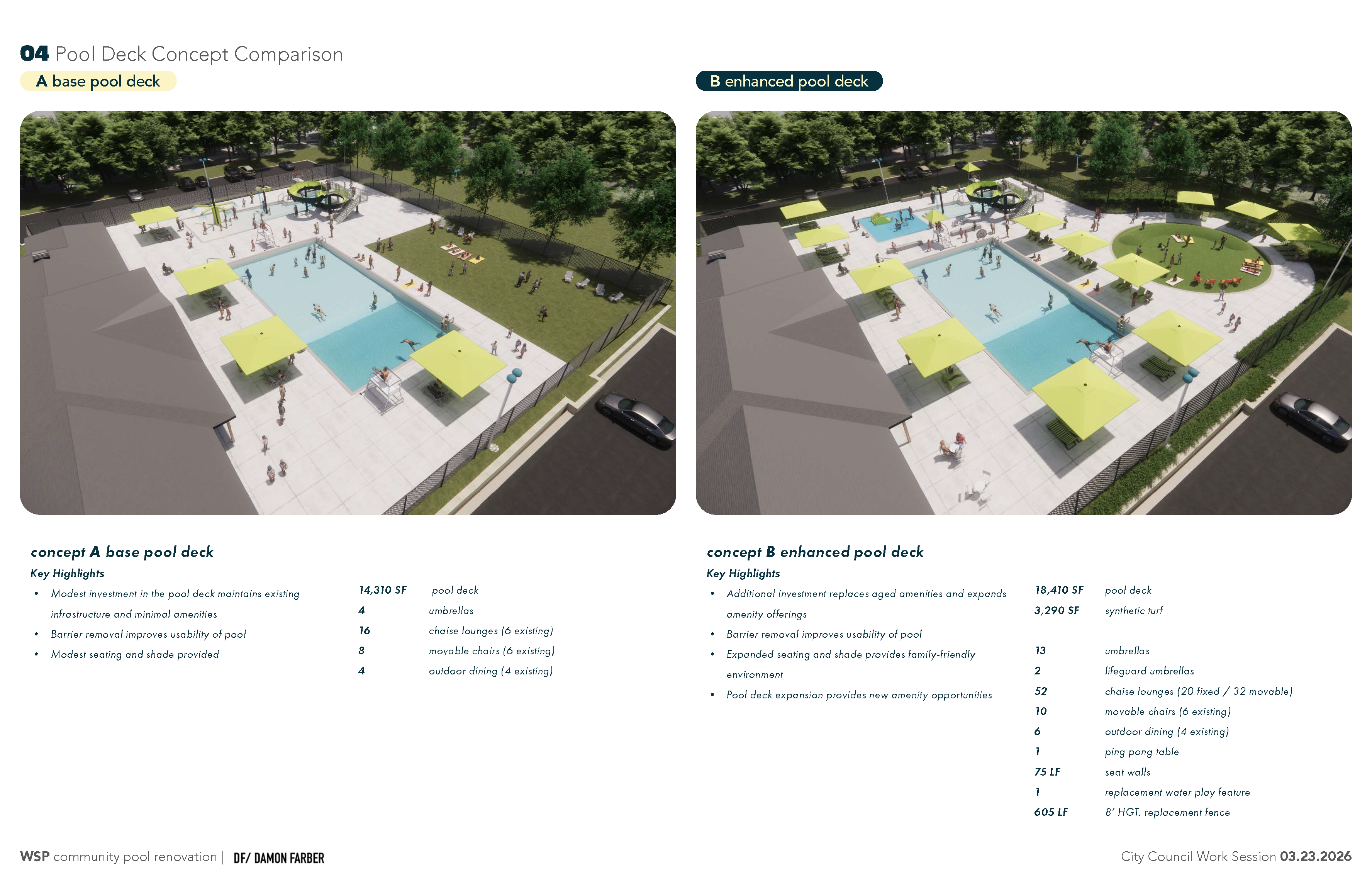

- Concept A - Base Pool Deck
- Renovation of existing slide, improvements to bathhouse building, pool finishes, surge tank replacement, mechanical system upgrades, pool deck concrete paving, accessibility improvements, barrier and ramp removal and lap swim improvements.
- Modest investment in the pool deck maintains existing infrastructure and minimal amenities
- Modest seating and shade provided
- Concept B - Enhanced Pool Deck
- Renovation of existing slide, improvements to bathhouse building, pool finishes, surge tank replacement, mechanical system upgrades, pool deck concrete paving, accessibility improvements, barrier and ramp removal and lap swim improvements.
- Transitions area of zero-depth entry pool into 'toddler zone' with new play features
- Expanded seating and shade provide a family-friendly environment
- Pool deck expansion provides new amenity opportunities
Upon review, the City Council chose to pursue Concept B - Enhanced Pool Deck. Additional planning and design will occur throughout the spring and summer.
Step 3: Construction
To limit impacts to the summer swim season, construction will occur in two phases.
- Phase One: This initial phase will involve rehabilitating the pool slide along with other minor enhancements, scheduled for late winter and spring of 2026.
- Phase Two: The larger phase will occur after the 2026 pool season and will include replacing the pool vessels, decking, and essential behind-the-scenes equipment. Other upgrades will enhance user experience, offering more seating and shade while giving the area a refreshed, modern appearance.
Completed Steps:
- June and Early September 2024: Aquatics consultant assesses the condition of the existing pool - with and without water.
- July-August 2024: City gathers community input.
- Winter 2024-25: Consultant offers initial report, including a status report of the existing pool's condition, future needs, and early cost estimates for 25-year and 50-year reinvest/replacement options.
- February 2025: City Council directs staff to continue explorations of two initial alternatives, including possible funding solutions.
- June 2025: City Council explores financial capacity to pursue pool project, and selects 25-year renovation option. City secures Amcon Construction to provide construction management services, and RFP for design services is released.
- September 2025: Design team led by Damon Farber selected for design services
- Fall 2025-Winter 2026: Design and additional assessment
- March 2026: City Council chooses to pursue Concept B - Enhanced Deck design alternative
Next Steps:
- Completion of plans (Spring-Summer 2026)
- Construction
- Phase 1: Spring 2026 (slide rehab)
- Phase 2: Fall 2026-Spring 2027 (remainder of improvements)
With so many variables and alternatives to consider, project timelines and our approach are almost certain to change.
Nearly 400 people participated in the first round of engagement. Thank you for your ideas and input.
Watch for more opportunities to provide your input.
Funding for the project comes from our park reserves/capital improvement fund.
As the private nonprofit champion of West Saint Paul’s parks, the Saint Paul Parks Conservancy partners with community members to enhance park facilities and programs to meet changing needs. For more information on the Conservancy's efforts to support the West St. Paul Pool visit: https://saintpaulparksconservancy.org/project/west-st-paul-leisure-pool/
Do you have questions about this project? If so, please Email Eric Weiss, Director of Parks and Recreation, at eweiss@wspmn.gov.
